Illustrative view of the Option A cable-stayed crossing east of the existing Auckland Harbour Bridge
Illustrative image, generated from the concept model. Not technical evidence.

Waitematā Crossing · Field Study 01

The bridge model exposed a path conflict and produced a ten-sheet record for specialist review.

A 3.0 metre path reduced to 2.2 metres, five corrected defects and seven open holds

Scroll

Detailing the stay anchorage exposed a material coordination problem: the first arrangement reduced the walking and cycling path from 3.0 metres to 2.2 metres. The model and drawing review made that conflict visible before the study advanced.

The study began with Nicolas Reid's May 2026 public proposal for a second Waitematā crossing. It developed the proposal's corridor and operating intent into a coordination model, two structural options and a ten-sheet stay anchorage package.

Revision P02 corrected five P01 defects, replaced an unsupported fatigue pass with a hold and carries seven open anchorage questions. The next test is whether a bridge specialist can continue a design change from that record. The package is preliminary and is not for construction or fabrication.

Alignment
2,000 m800 m main span
Deck
38.0 mtraffic, transit, walking, cycling
Anchorages
256modelled housings
Sheets
10ST-0600 to ST-0609
Open holds
7H1 to H7

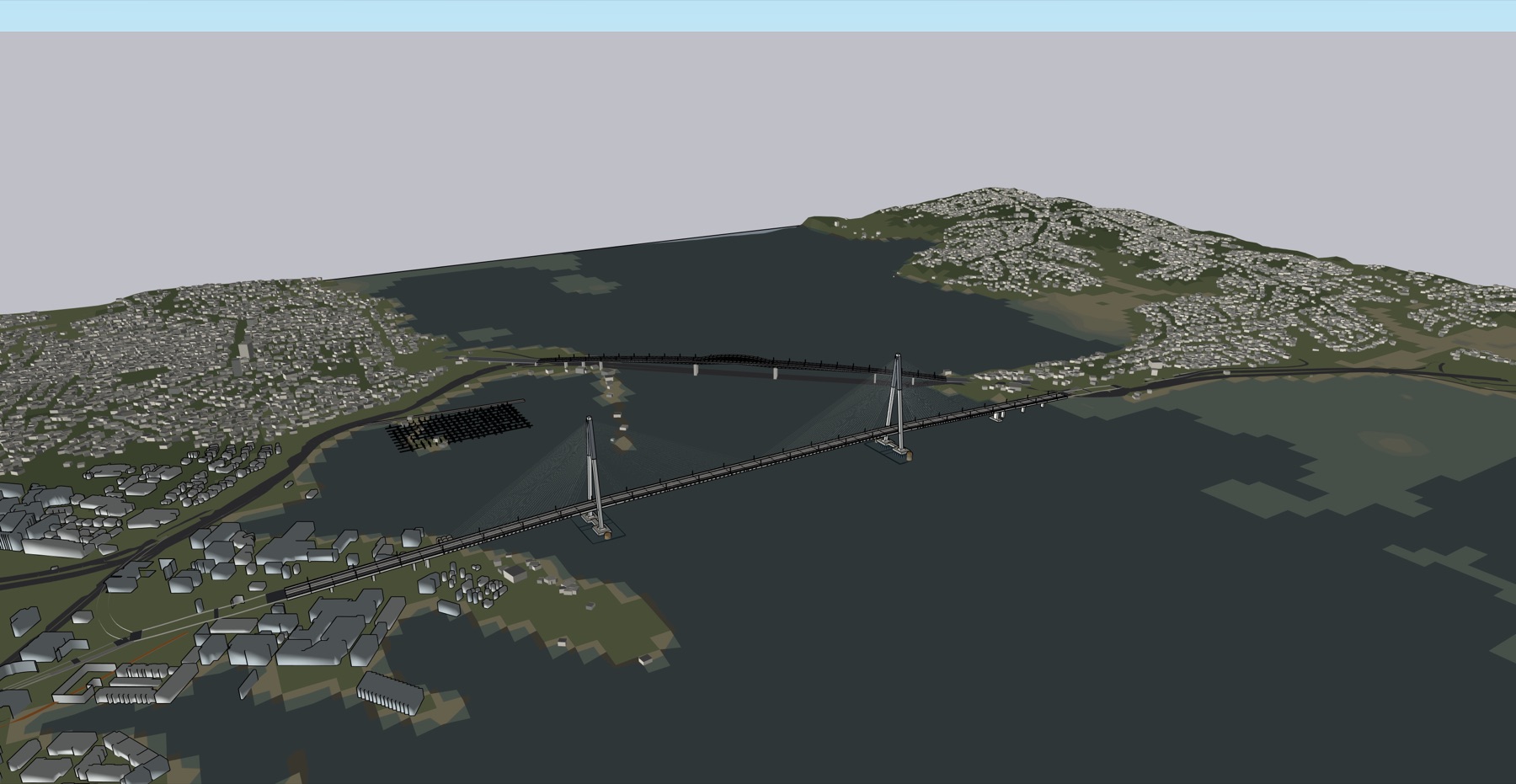

Option A cable-stayed crossing seen obliquely across the harbour, in the modelled Auckland context
Fig. 02Option A in the harbour context · untreated model view
01The brief

The model develops Landform's bridge geometry within the proposal's corridor and operating intent.

The proposal describes a multimodal bridge just east of the existing crossing, running from the Onewa interchange to the Victoria Park viaduct. It would carry southbound motorway lanes, two-way rapid transit and paths for walking and cycling, with the existing bridge working alongside it as one system.

Those inputs establish the form and operating intent. The table separates the published proposal from the geometry developed for this study.

Several parts of the proposal remain outside the model: the two-bridges-as-one-system operating allocation, Te Onewa station, and the Westhaven and St Marys Bay outcomes. The current model carries two lanes each way; the proposal assigns four southbound motorway lanes to the new bridge.

Corridor
Onewa to the Victoria Park viaduct, east of the existing bridge. Both tie-ins are represented in the harbour context model.
Length
Proposal 1,800 to 2,000 m. Model 2,000 m: 800 m main span, 350 m side spans, 250 m approaches.
Deck
Proposal around 38 m, multimodal. Model 38.0 m carrying walking, cycling, transit and traffic.
Clearance
Proposal 43 m, matching the existing bridge. Model 43.0 m held over a 500 m navigation channel.
Structure
Proposal cable-stayed. Model Option A cable-stayed, with Option B tied arch tested as a comparator.
Landform additions
The 800 m main span and the A-frame towers are design developments, not prescribed by the proposal.

Source: Greater Auckland, "Build this brilliant bridge", 27 May 2026

02How the study was made

Named inputs connect the source material to the model, calculations, drawings and review record.

SOURCES Public proposal corridor, deck, clearance Open data LINZ DEM, soundings, OSM Standards register PTI, fib, AS/NZS, NZTA NAMED INPUTS params_P02.json controlled parameter set AI-ASSISTED WORK Coordination model SketchUp, scripted Ruby Preliminary sizing python, prelim_design.json Drawing package generated A3, ten sheets REVIEW Consistency screen 70 checks, scripted Adversarial pass a second model, read-only Human review decisions and findings OUTPUT Revision P02 with holds carried corrections update named inputs before affected outputs are regenerated CROSS-MODEL REVIEW RULE The model that records a finding cannot verify its closure. A second model checks the fix on the following cycle, and the ledger accepts verification only from an actor other than the one that recorded the correction.
Models from Anthropic and OpenAI supported research, modelling and cross-model critique. I set the direction, assessed each finding and selected the published outputs.
03The model

One SketchUp file contains the harbour context, both structural options and the anchorage detail.

The coordination model is a single SketchUp file, waitemata_crossing_city_context_P02.skp, carrying 798 groups and about 166,000 faces across 21 tags and 16 saved scenes. A scripted build allows changes to named parameters to rebuild the affected geometry.

The context is open data. Ground comes from the LINZ one metre elevation model, the seabed from LINZ hydrographic soundings merged into the same surface, and the surrounding city from OpenStreetMap building footprints with heights taken from tags where they exist.

The context exposed an early placement error. The existing harbour bridge was first placed from a geocoded position and ended in mid-air over deep water. Its abutments were then re-derived from the ground surface at the tightest crossing recorded by the elevation model. Later coordination depends on both structures meeting the recorded terrain.

Model file
waitemata_crossing_city_context_P02.skp
Contents
798 groups, 165,795 faces, 21 tags, 16 scenes
Ground
LINZ 1 m elevation model, Auckland 2024
Seabed
LINZ hydrographic soundings, inverse-distance merged
City
OpenStreetMap footprints, heights from tags where present
Water depth on the alignment
About 15 m at the north tower, 6 m at the south
The 38 metre multimodal deck seen along its length towards the tower and the city
Fig. 03The 38 m deck, looking south · untreated model view
Eye level view along the walking and cycling path beside the deck edge
Fig. 04The active path at eye level · untreated model view
04Options

Option A advanced to anchorage detailing. Option B remains held on its erection method.

Option A develops the proposal's cable-stayed form: an 800 metre main span between twin A-frame towers, 350 metre side spans with anchor piers, and 250 metre approaches. It is the option carried into the detail package.

Option B is a half-through tied steel truss arch of 550 metres, tested as a comparator on the same deck. Its preliminary screens report a total horizontal thrust of 344.4 MN, 172.2 MN per rib, 32.4 metre hanger spacing and 62 strand hangers, with in-plane utilisation 0.663, out-of-plane 0.858 and pattern-load beam-column interaction 0.81.

Option B passed 69 of 70 checks in the current consistency screen. The unresolved check is the half-arch erection method, so the option remains a comparator and did not advance to detailing.

The two options are mutually exclusive alternatives on one corridor. They are shown here as separate figures with a matched camera, never combined into a single scene.

QuantityOption AOption B
FormCable-stayedHalf-through tied arch
Main span800 m550 m
Deck38.0 m38.0 m
Clearance43.0 m43.0 m
StatusDeveloped to detailP02Comparison only
Blocking itemSeven anchorage holdsErection method

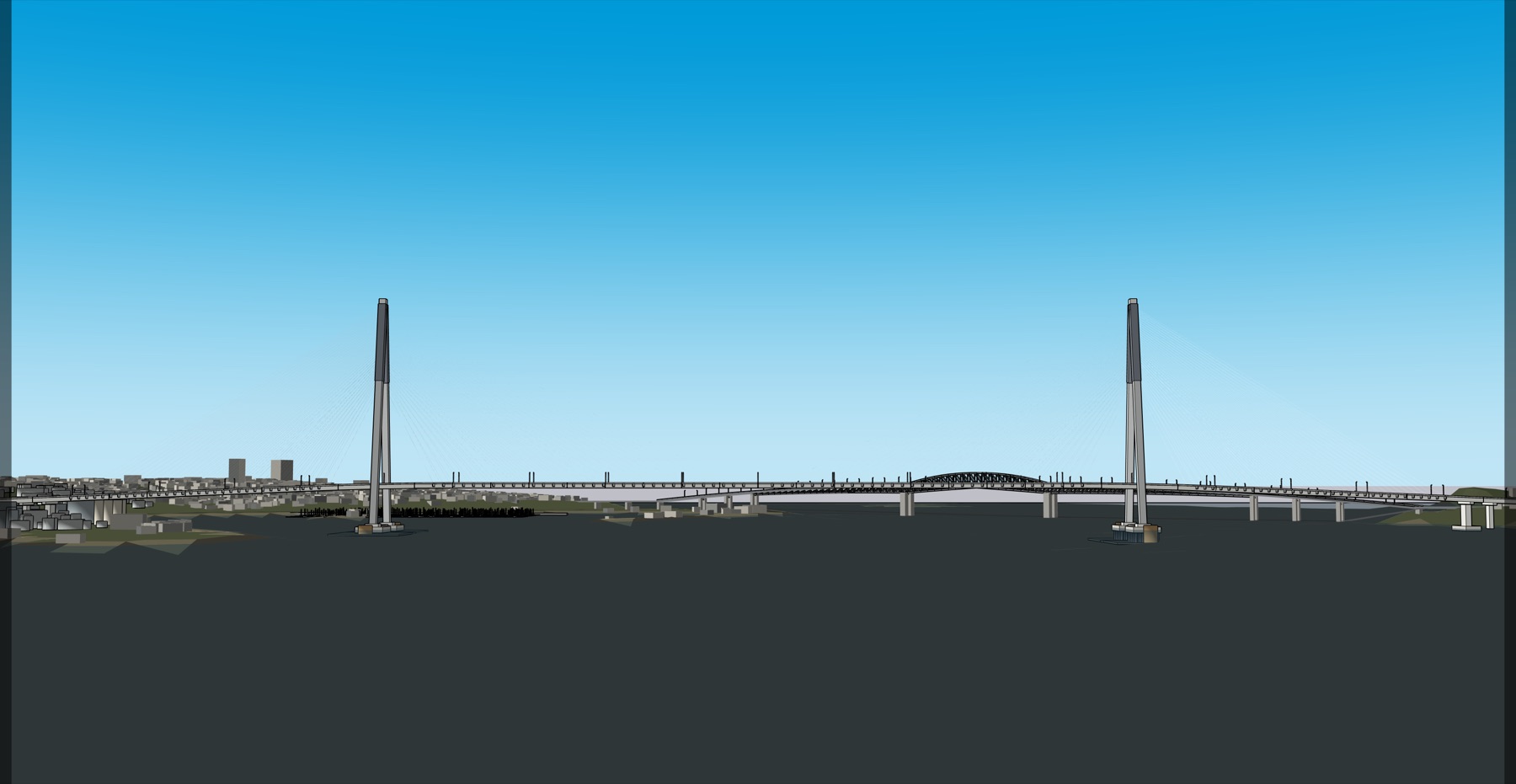

Elevation of the Option A cable-stayed crossing
Fig. 05Option A, cable-stayed · matched elevation, untreated

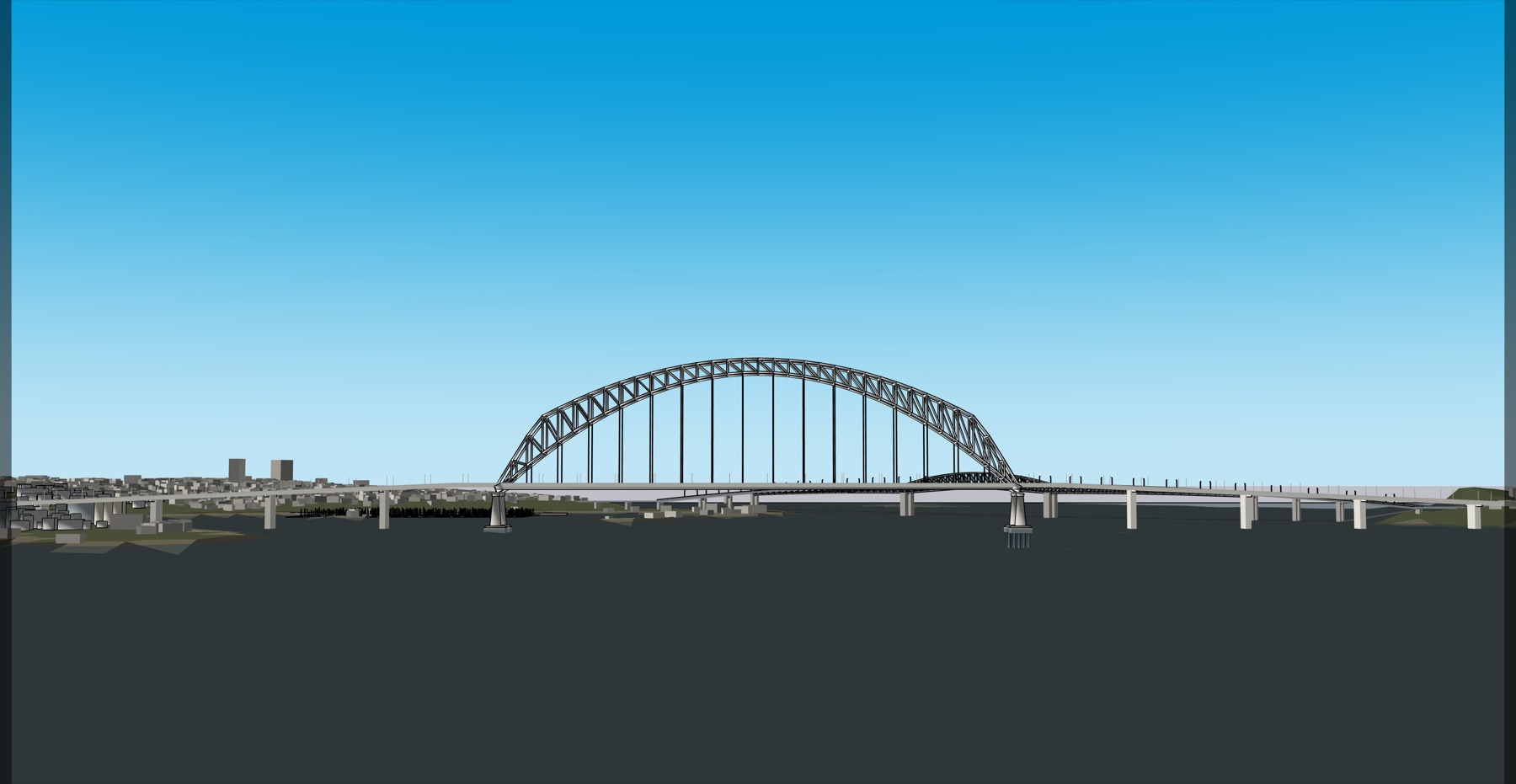

Elevation of the Option B tied arch crossing
Fig. 06Option B, tied arch · matched elevation, untreated
05The detail

The first anchorage arrangement reduced the three-metre walking and cycling path to 2.2 metres.

The model originally carried a blister anchorage: a raised anchor block on the deck plate, with the stay entering above the running surface. The arrangement occupied part of the declared three-metre active path, leaving 2.2 metres clear at each of the 32 positions per face.

Detailing exposed a coordination defect that was not visible in the general arrangement.

Four families of stay-to-deck anchorage were compared. The external node outboard of the deck edge was developed, with the edge girder and transverse diaphragm retained as the fallback.

Family D was selected to keep the path clear and support replacement. Its structural efficiency has not been established, and family C has more precedent. No built example of an outboard anchorage on a bridge of this class was identified in the sources reviewed, so acceptance remains hold H1. If H1 cannot be closed, the package reverts to family C and the continuous active path is lost.

FamilyArgument forArgument against
A · anchor box inside the girderShort direct load path, protected, deck clearConfined stressing; fatigue-critical region inside primary structure
B · blister on the deck topSimplest fabrication, fully accessibleOccupies the deck surface; leaves 2.2 m of a 3.0 m path
C · edge girder with diaphragmDeck surface clear; substantial precedentFatigue-critical welded attachment; access still internal
D · external node outboarddevelopedPath continuous at every position; anchor reachable and replaceableAdds torsion and eccentric transfer needing 3D proof; no built precedent identified in reviewed sources
Reference stay
BACK-01, 73 strands
Preliminary SLS demand
8.242 MN against a 9.165 MN threshold at 45% GUTS, ratio 0.899
Preliminary ULS demand
11.319 MN against a 13.239 MN threshold at 65% GUTS, ratio 0.855
Cable GUTS
20.367 MN. The anchorage must transmit this, not the design force
Stay inclination at deck
30.6 degrees
Back and main fan pitch
8,387 mm and 10,484 mm
Assemblies
2 towers × 2 fans × 32 positions × 2 deck edges = 256
Provisional plan gap
0.30 m between the path outer face and the node inner face

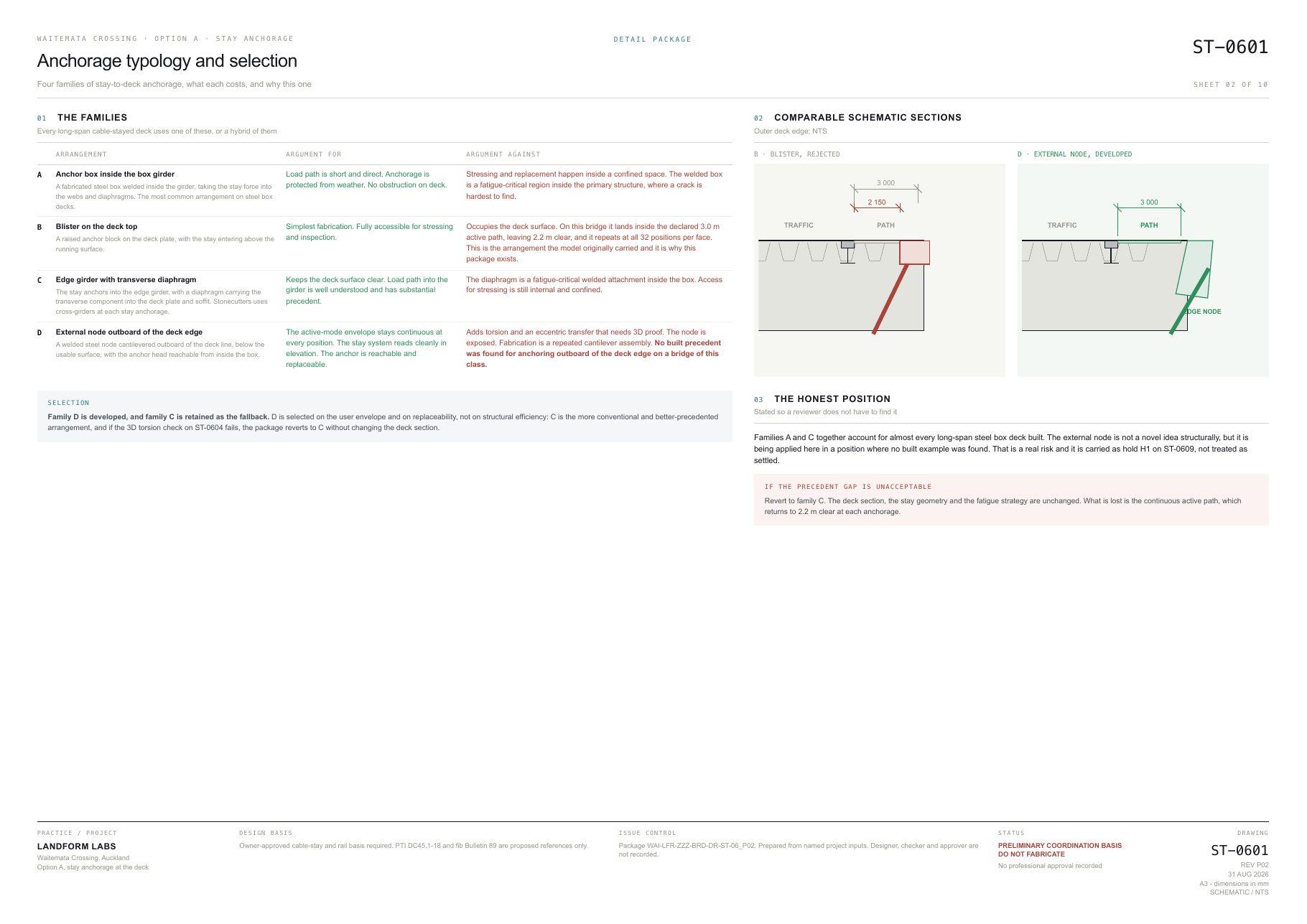

Sheet ST-0602, the anchorage zone general arrangement in section, elevation and plan
Fig. 07ST-0602 · one anchorage bay in section, elevation and plan
06The package

The ten-sheet package records the anchorage decision, supporting evidence and seven open holds.

Package WAI-LFR-ZZZ-BRD-DR-ST-06 revision P02 contains ten A3 sheets. Each one carries a decision, the evidence behind it and the hold that remains. The set is a preliminary coordination basis and is stamped do not fabricate, with no designer, checker or approver recorded.

The first sheet states the governance position. The NZTA Bridge Manual excludes cable-stayed bridges and railway loading, so a project-specific cable-stay and rail design basis, documented departures and special studies would all be required. The structure would be managed as a Category 1 structure under the Highway Structures Design Guide, including a wholly independent design review.

Sources are graded on each sheet: E1 for primary or official material, E2 for secondary or inferred, E3 for assumption. Supplier geometry sits at E2, because no stay system has been selected and two published bearing plates differ by 35 millimetres in diameter, which alone changes the node end diaphragm.

ST-0600

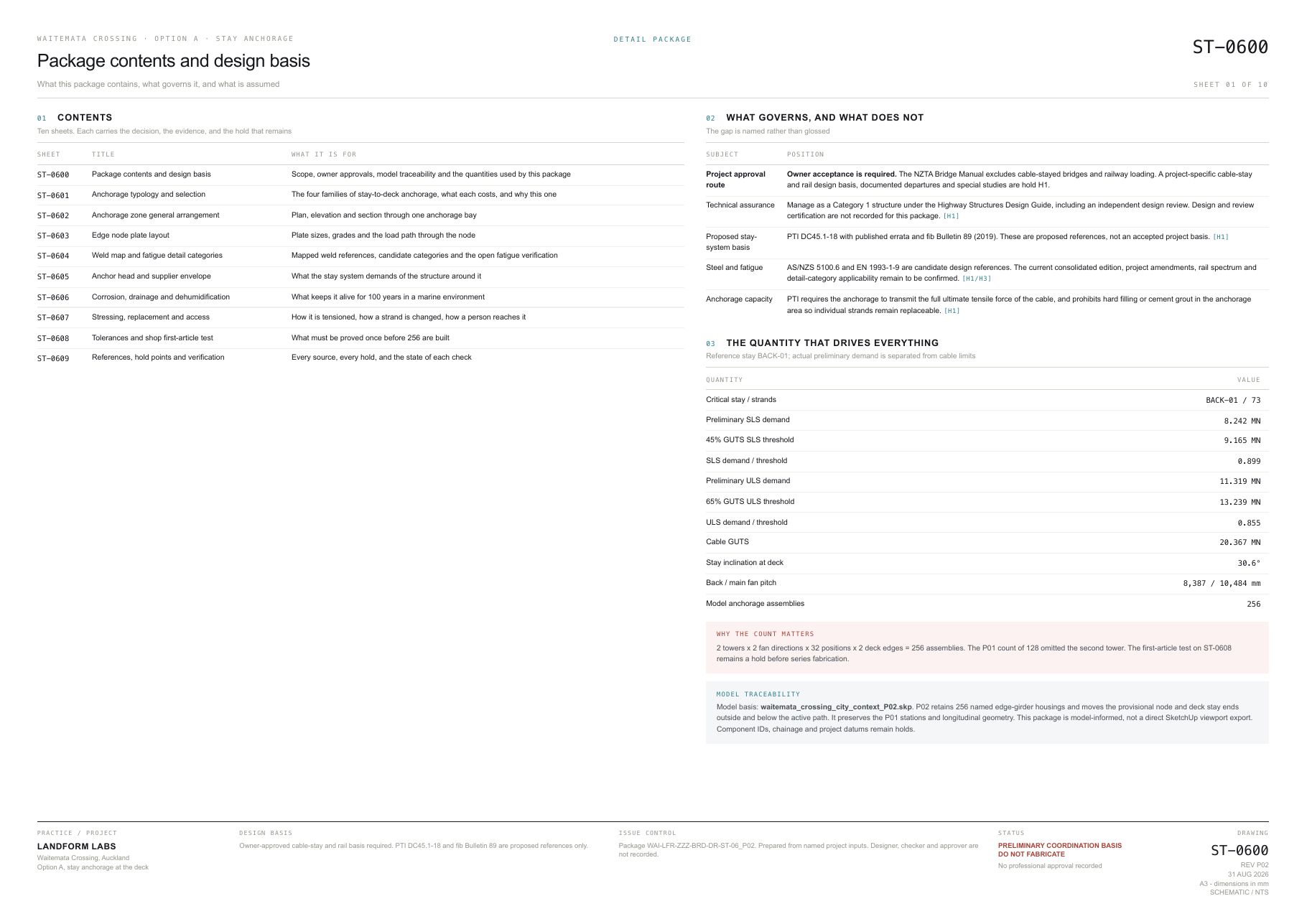

Package contents and design basis
ST-0601
Anchorage typology and selection
ST-0602
Anchorage zone general arrangement
ST-0603

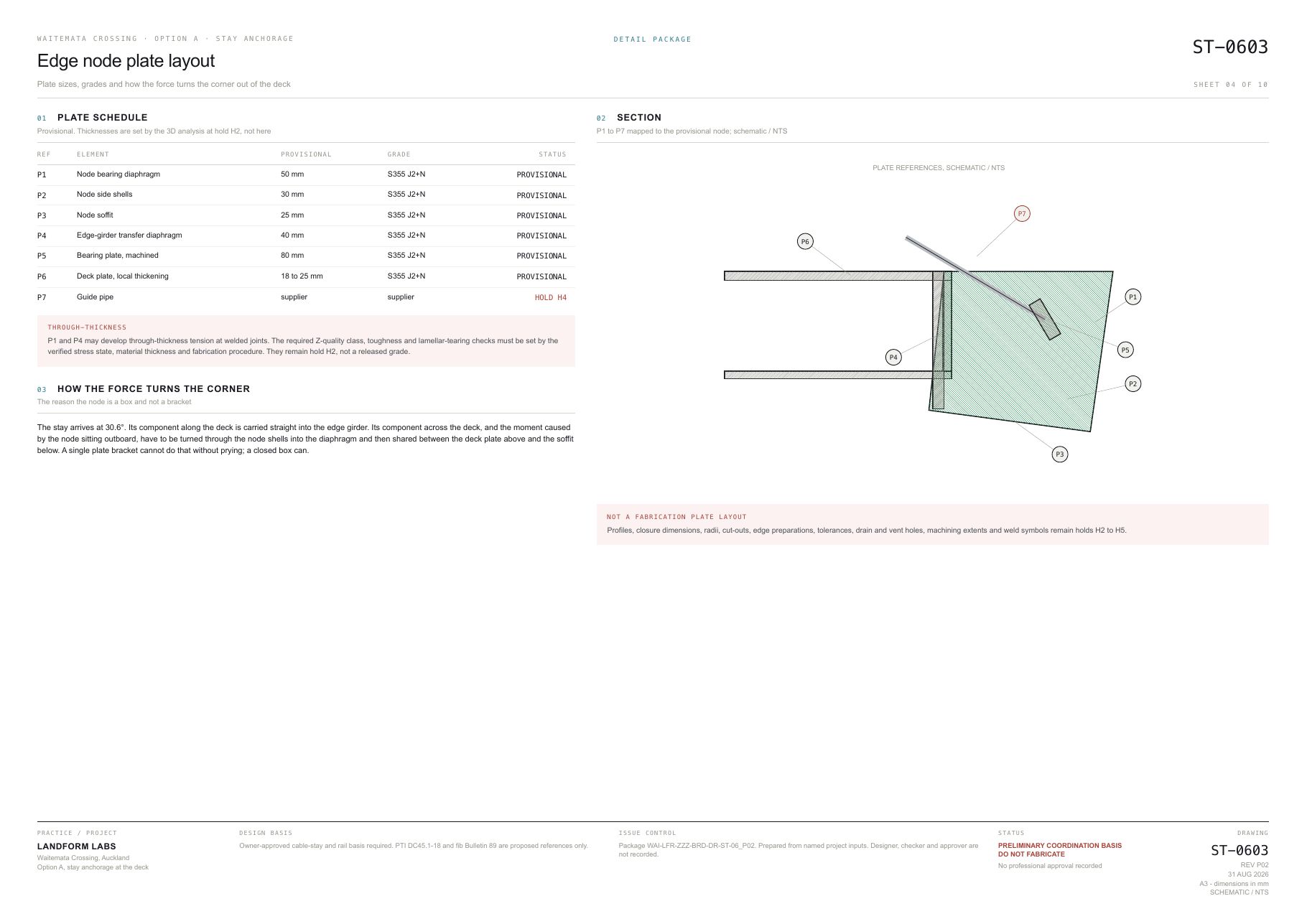

Edge node plate layout, P1 to P7
ST-0604

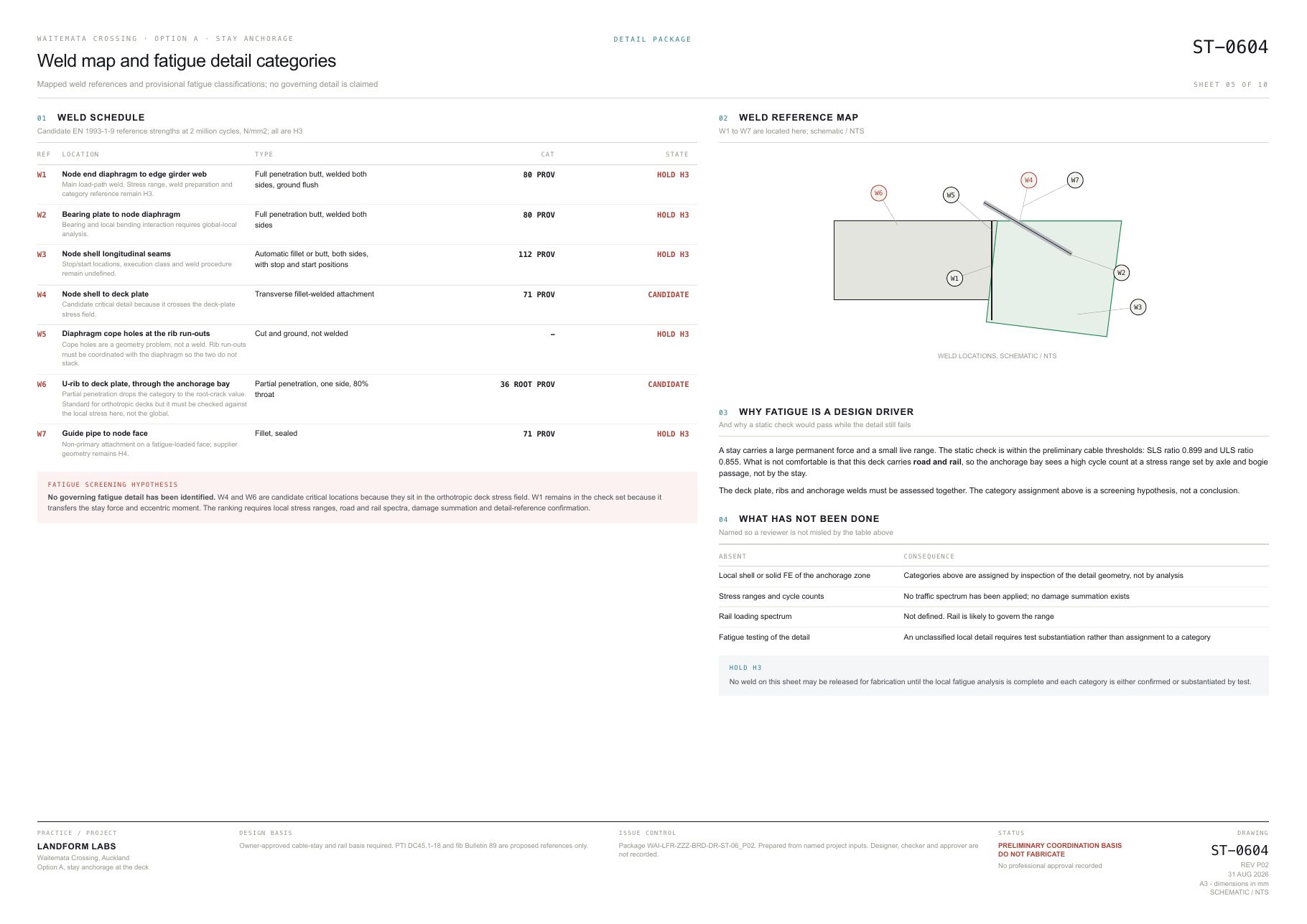

Weld map and fatigue detail categories, W1 to W7
ST-0605

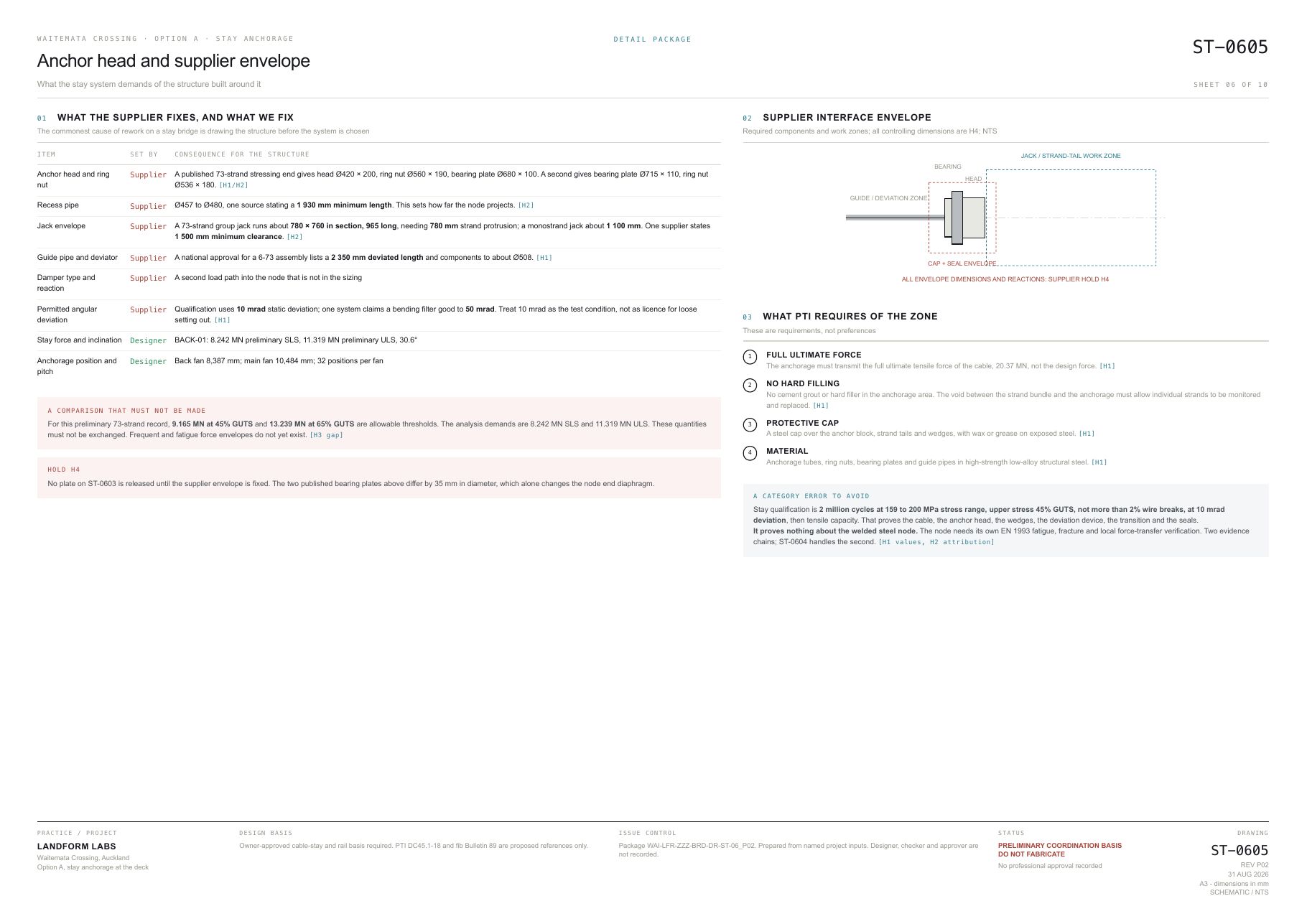

Anchor head and supplier envelope
ST-0606
Corrosion, drainage and dehumidification
ST-0607

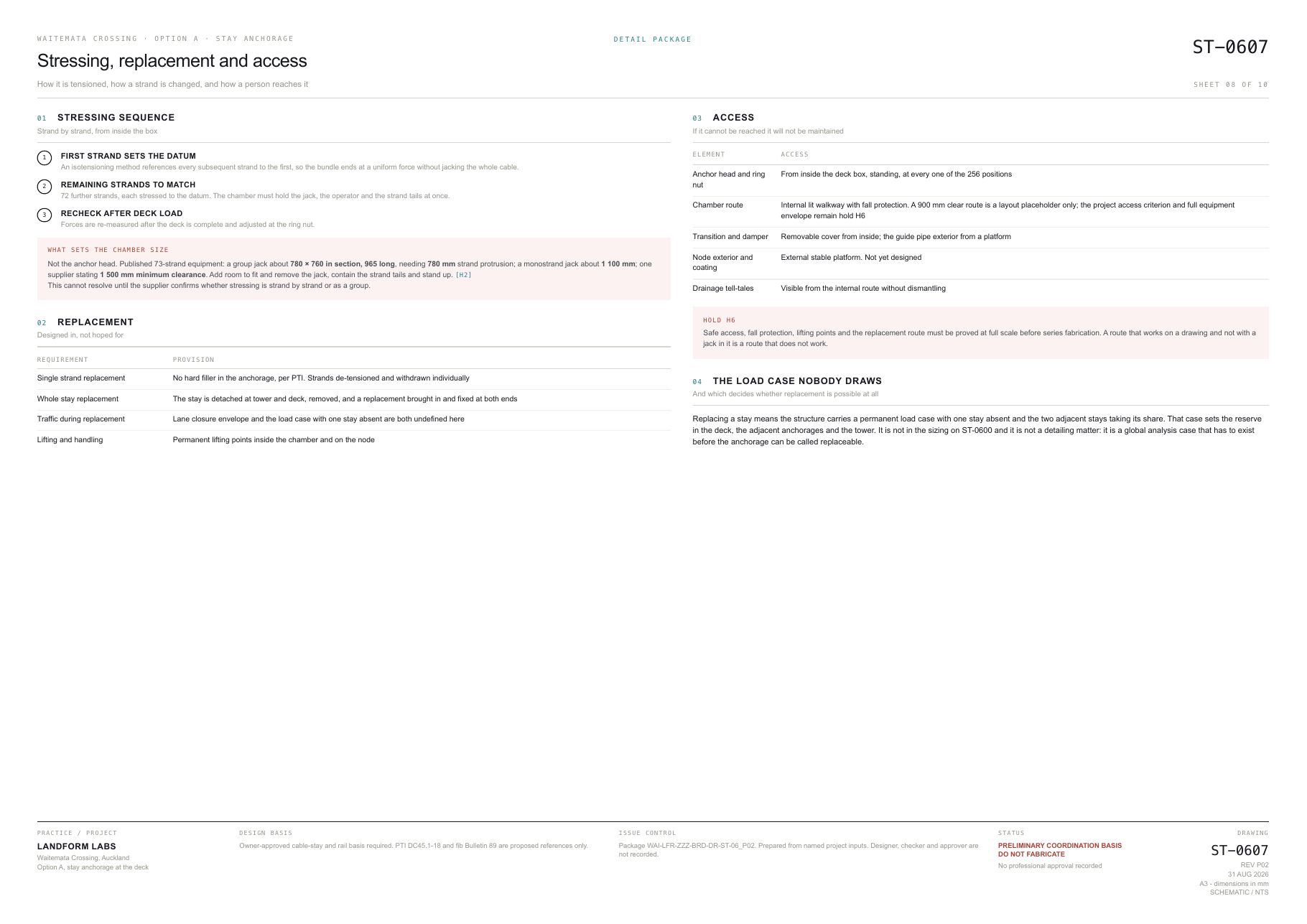

Stressing, replacement and access
ST-0608
Tolerances and shop first-article test
ST-0609
References, hold points and verification

Ten A3 sheets, package WAI-LFR-ZZZ-BRD-DR-ST-06 revision P02, 31 August 2026. Preliminary coordination basis. Do not fabricate.

07Review and revision

P02 corrected five P01 defects and replaced the unsupported fatigue pass with hold H3.

Revision P01 received a structured review. P02 records a response to each of six findings: five changes to the model or document and one withdrawn claim.

The register lists ten sheets. The document contains nine.

Document integrityST-0607 rendered as a header only and ST-0608 was nested on the same page. P02 contains ten separate A3 sheets.

The assembly count omits the second tower.

128 corrected to 256Two towers, two fan directions, 32 positions and two deck edges give 256 assemblies. P01 had counted 128. The quantity affects the first-article requirement and fabrication planning.

Demand and capacity are being quoted as if they were the same class of number.

Quantities separatedPreliminary demand, allowable thresholds and the cable breaking force are now stated separately and labelled. They must not be exchanged.

One pitch is quoted for two different fans.

8,387 and 10,484 mmBack-fan and main-fan spacing are reported separately.

The anchorage extends 0.85 m into the walking and cycling path.

Path clearance restoredP02 moves the housing outside the three-metre path and records a provisional 0.30 m plan gap in both the model and the drawings. Supplier confirmation remains open.

Fatigue is written as a pass. It has not been analysed.

Claim withdrawn, hold openedNo governing fatigue detail has been identified. The categories on ST-0604 are a screening hypothesis assigned by inspection of the detail geometry, and they are now labelled as such under hold H3.

External validation found a separate defect in the coordinate frame. An earlier frame was left-handed, so every three-dimensional view mirrored Auckland in plan: the existing harbour bridge appeared east of the new alignment when it is west. Three adversarial review cycles and the automated checks missed the error because each relied on the same internal frame. Comparison with external ground truth exposed it. The frame was corrected and the model rebuilt.

The consistency screen has a clear limit: it tests agreement with the project's selected ranges. Design adequacy and external ground truth require separate checks.

08Verification record

P02 records four passed checks and seven open holds against named evidence.

CheckStateEvidence
Anchorage typology screenedPASSFour concept families compared on ST-0601. Professional acceptance remains H1
Demand and thresholds separatedPASSBACK-01 demand 8.242 and 11.319 MN; thresholds 9.165 and 13.239 MN
Assembly quantity reconciledPASS2 towers × 2 fans × 32 × 2 edges = 256
Model path clearancePASS256 nodes outside 19.0 m; path outer edge 18.7 m; stay axis 20.0 m
Project design basis acceptedHOLDOwner-approved cable-stay and rail basis, departures and Category 1 review not recorded. H1
Built precedent for the arrangementHOLDNone identified in the sources reviewed for anchoring outboard of the deck edge on a bridge of this class. H1
Deck torsion from eccentricityHOLDNot analysed. H2
Governing fatigue detail identifiedHOLDNot established. W4 and W6 are candidates; W1 remains in the check set. H3
Fatigue categoriesHOLDAssigned by inspection, not by analysis or test. H3
Supplier geometryHOLDSystem not selected. Every head-related dimension is provisional. H4
One stay absentHOLDThe global load case does not exist, so the anchorage cannot yet be called replaceable. H6

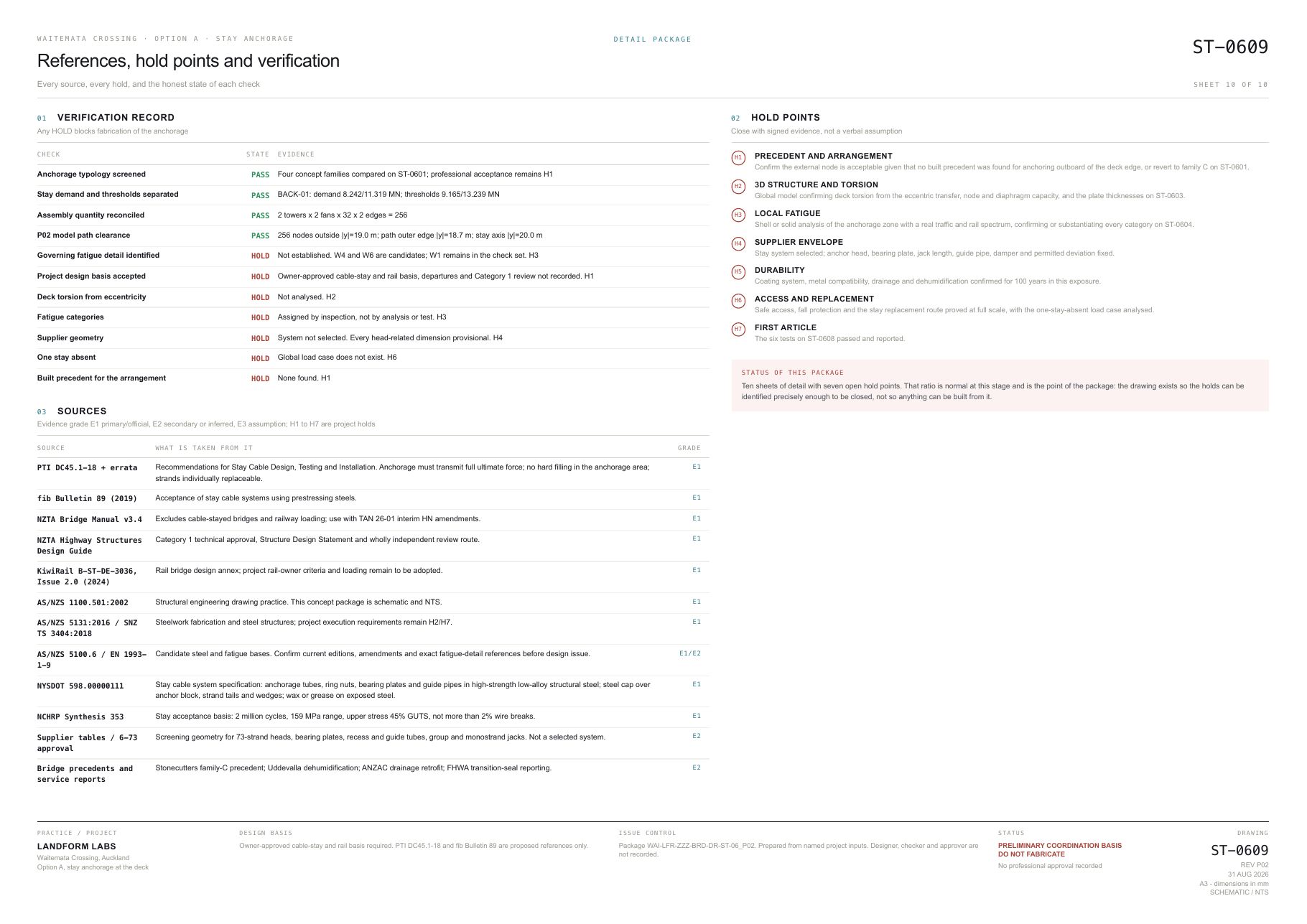

Source: ST-0609, package revision P02

09Open holds

Seven holds define the evidence needed before the anchorage can advance.

The ten-sheet package records seven holds for this anchorage detail and remains marked Do not fabricate. Each hold names the evidence required for closure. Wider transport, global structural, foundation, geotechnical, wind, seismic, vessel impact and owner approval questions sit outside the package's scope.

H1

Precedent and arrangement

Confirm the external node is acceptable given that no built precedent was identified in the sources reviewed, or revert to family C.

H2

3D structure and torsion

A global model confirming deck torsion from the eccentric transfer, node and diaphragm capacity, and the plate thicknesses on ST-0603.

H3

Local fatigue

Shell or solid analysis of the anchorage zone with a real traffic and rail spectrum, confirming or substantiating every weld category.

H4

Supplier envelope

Stay system selected, with anchor head, bearing plate, jack length, guide pipe, damper and permitted deviation fixed.

H5

Durability

Coating system, metal compatibility, drainage and dehumidification confirmed for one hundred years in this exposure.

H6

Access and replacement

Safe access, fall protection and the stay replacement route proved at full scale, with the one-stay-absent load case analysed.

H7

First article

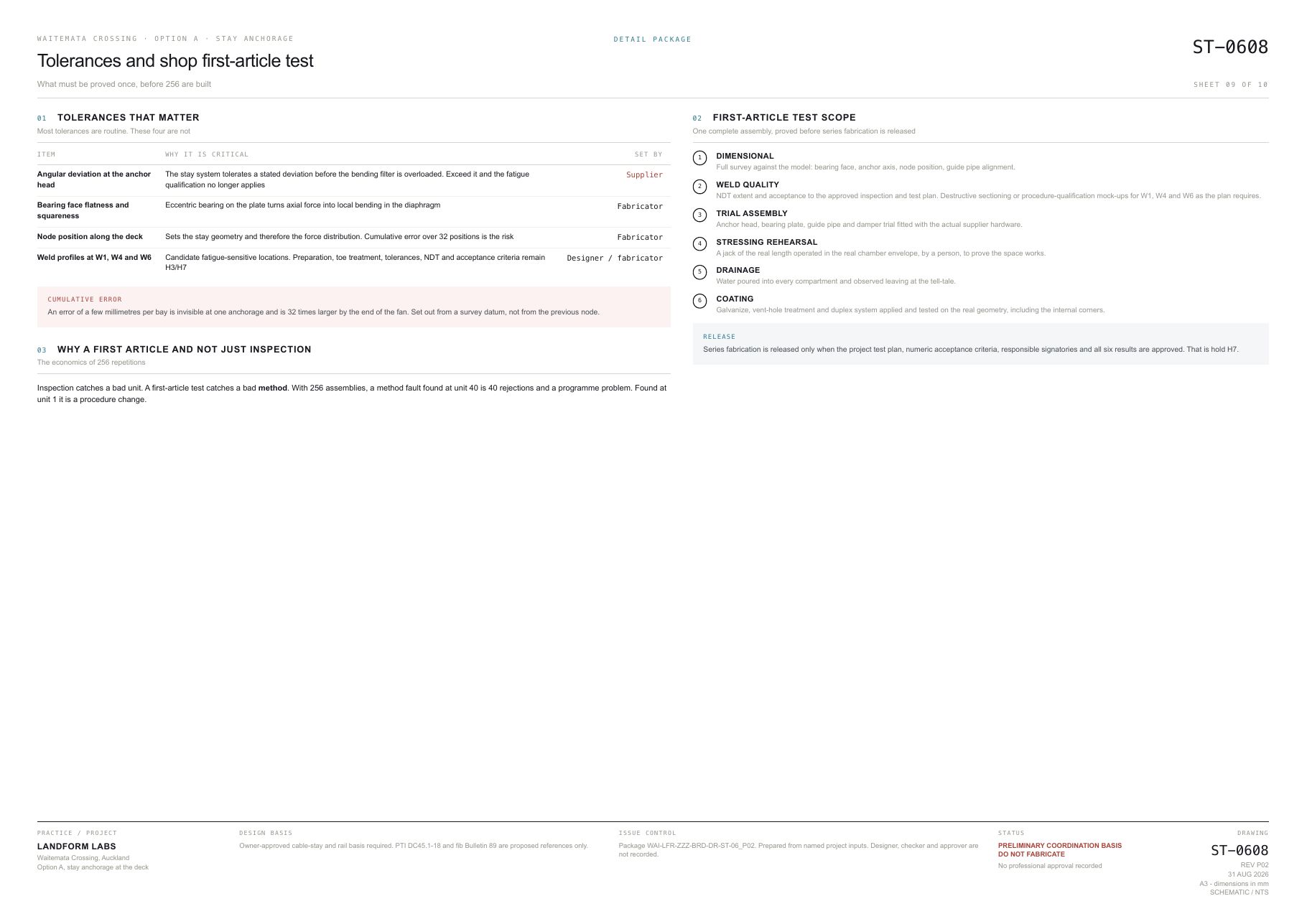

The six tests on ST-0608 passed and reported before series fabrication of 256 assemblies is released.

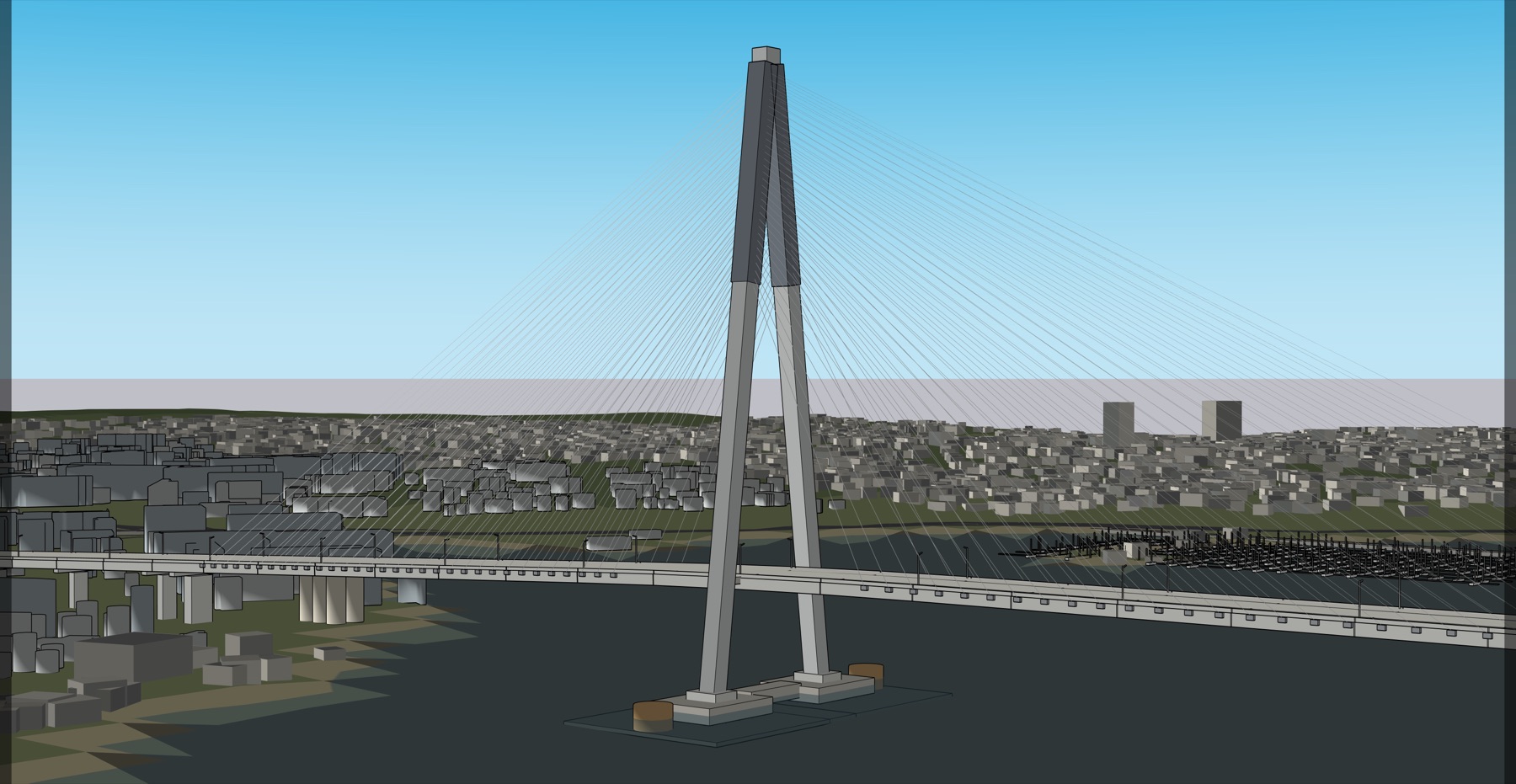

The tower head and the stay fan, showing the load path into the A-frame legs
Fig. 08Tower head and stay fan · untreated model view
The north tower foundation below water, showing the pile caps, piles and vessel protection
Fig. 09North tower foundation, below water · untreated model view
10What I learned running it

The workflow produced model and drawing revisions. Assessing their technical adequacy still requires a bridge specialist.

The workflow produced the model, drawings and revision record. Assessing evidence, technical gaps and option credibility requires bridge-engineering knowledge I do not have. Every technical output therefore needs specialist review.

It linked sources to named inputs, rebuilt geometry after input changes and maintained a clear sequence of next actions. No conventional baseline was recorded for time, cost or review effort, so the study makes no productivity claim.

The next test should be run with bridge specialists, using a firm's own project records, reference details and design criteria. It will examine whether specialist decisions remain connected to the evidence and generated outputs.

Workflow contribution

Assembled sources, linked them to named inputs, rebuilt geometry, generated drawings and ran the screen.

Human decisions

I set the brief, chose the option, assessed every finding and decided which conclusions the package supported.

Specialist work still required

Structural verification, precedent confirmation, supplier selection, specialist design and professional approval.

Not measured

No conventional baseline has been recorded for time, cost or review effort. No productivity claim is made.

11The verdict

The package is partly traceable and reviewable. Specialist handover remains untested.

The study produced an anchorage package and a record of its corrections. Bridge-wide continuity and independent specialist handover remain untested. One generalist operator ran the study using public-source information, with no project surveys, no multidisciplinary coordination, no independent specialist review and no professional approval.

The next stage will test whether a bridge specialist can work in the early model while its evidence, assumptions, revisions, drawings and unresolved questions remain connected to each decision. This study does not demonstrate autonomous design, compliance, certification or measured productivity.

Handover will be tested by asking a specialist to change the named parameters, regenerate the model and drawings, and update the affected holds without reconstructing the project history.

Traceable
Partial
Coherent
Partial
Reviewable
Partial
Ready to continue
Untested

Boundary. Independent concept study. Preliminary coordination basis only. No professional design, check, certification or approval is recorded. Geometric coordination is not structural acceptance. Not for construction or fabrication. All seven anchorage holds remain open.

12The documents

Both issued documents are available with their open holds intact.

The field study is a nine-page account of the work. The anchorage package is its ten-sheet technical record. Both are published unchanged from their issued versions, including the holds printed on the sheets.

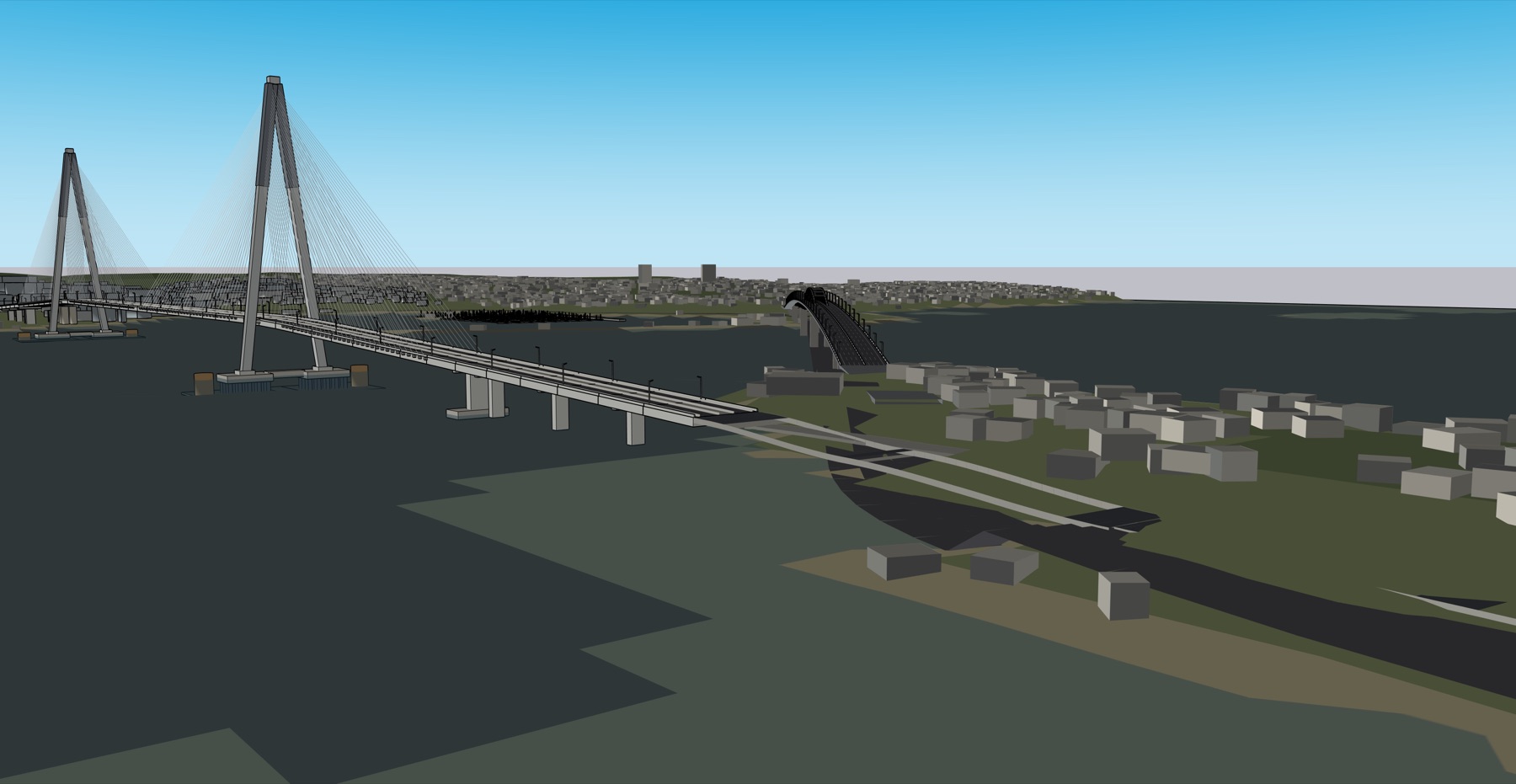

The northern tie-in at Onewa, where the new alignment meets the existing motorway network
Fig. 10The Onewa tie-in · untreated model view

The related studies
